Factory Acceptance Testing (FAT) and Site Acceptance Testing (SAT) are two complementary validation stages for pharmaceutical equipment. FAT is done at the equipment manufacturer’s facility (before shipping) to verify all specifications and functions meet the customer’s requirements. SAT is performed after installation at the customer’s site to confirm the machine works correctly in the actual production environment. Together, FAT and SAT help catch issues early (saving time and cost) and ensure GMP compliance. This article explains FAT vs SAT in detail – covering what each test verifies, key differences, how they fit into the IQ/OQ/PQ lifecycle, sample checklists for packing lines (blister, capsule, tablet, cartoning), and buyer best-practice questions.

A Factory Acceptance Test (FAT) is a formal, documented evaluation of equipment at the manufacturer’s site, conducted before the unit is shipped to the customer. It verifies that the machine has been built to the agreed User Requirements Specification (URS) and is functioning correctly. During FAT, the vendor and customer (or their representatives) execute an approved FAT protocol of test cases and checklists. Typical objectives include demonstrating compliance with specifications, catching defects early, and giving the buyer confidence that “the equipment is ready to ship”.
In FAT, the focus is on standalone performance and adherence to design. It generally includes:
A successful FAT ends with a signed FAT report, itemizing passed tests and listing any issues to fix before shipment. Essentially, FAT ensures “the system is ready to be shipped” by verifying its core functions under controlled factory conditions.
The FAT typically takes place after the machine is fully assembled but before it leaves the manufacturer’s floor. It follows design qualification (if any) and precedes delivery. Key participants usually include vendor engineers and technicians, and representatives from the buying company (QA/validation engineers, production staff). The buyer’s team should arrive prepared, often bringing the URS, test protocols, and any specialized materials to run. The FAT is the buyer’s last chance to catch major discrepancies under the supplier’s control.

Figure: A pharmaceutical blister packaging machine undergoing acceptance testing. In a rigorous FAT, every subsystem (forming, sealing, feeding, controls) is checked against the URS. A subsequent SAT then repeats key functional tests after installation in the end-use environment.
A Site Acceptance Test (SAT) is a documented test performed at the customer’s facility after the equipment is delivered and installed but before it is released for production. SAT re-verifies that the machine meets requirements in its actual operating context. In SAT, the equipment is checked for proper installation, utilities hookup, system integration, and final performance.
SAT typically includes:
A successful SAT ends with an SAT report or certificate signed by both vendor and customer. It provides documented evidence that “the equipment/system has been delivered in good condition and has not been affected by transportation” and now operates correctly on site. In practice, a thorough SAT gives confidence that the machine is ready for the next phase of validation (IQ/OQ/PQ) or routine production.
In short, FAT and SAT are sequential checkpoints: FAT catches defects early in the factory; SAT catches any remaining issues once the machine is on-site. Both are crucial for GMP compliance and risk management.
FAT vs SAT at a Glance
| Feature | FAT (Factory Acceptance Test) | SAT (Site Acceptance Test) |
| Where & When | At vendor’s facility, before shipping. | At customer’s site, after installation. |
| Purpose | Verify the machine meets design/URS specs and works stand-alone. | Verify the machine functions correctly in the actual production line (utilities, environment, integration). |
| Environment | Controlled factory conditions (vendor utilities). | Real plant conditions (actual air, power, temperature). |
| Testing Scope | Detailed functional tests against contract specs; simulate process using representative materials if possible. | Check installation (IQ), then repeat core functionality and performance with final product/setup; test integration with upstream/downstream equipment. |
| Acceptance Criteria | Based on the user requirements and agreed test plan (e.g. speed, accuracy). | Confirms site-adjusted performance (e.g. consistent production quality, utility parameters) meet criteria. |
| Documentation | Formal FAT protocol, test records, punch-list, final FAT report. | Formal SAT protocol (often simpler), deviation log/punch-list, sign-off, and traceability to URS. |
| Outcome | “Equipment approved for shipment” (or list of fixes). | “Machine accepted on site” (or list of remaining issues to fix). |
This table highlights the key distinctions: FAT is all about proving the machine is built to spec before it leaves the factory, while SAT proves it still meets requirements after installation in its working environment. Both are typically required under GMP/Annex 15 guidance.
FAT and SAT are part of the larger qualification lifecycle for GMP equipment. In a typical project flow, you start with the User Requirements Specification (URS) and Design Qualification (DQ), then proceed to FAT, delivery, installation, SAT, and finally IQ/OQ/PQ on site. The mermaid diagram below illustrates this sequence:

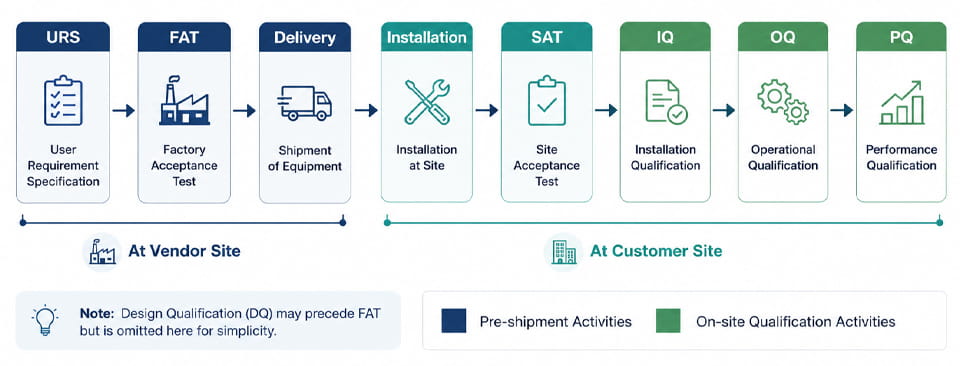

Figure: Qualification lifecycle flow. After defining URS, a Factory Acceptance Test (FAT) is performed at the vendor site. Then the equipment is shipped and installed, followed by a Site Acceptance Test (SAT). Finally, Installation Qualification (IQ), Operational Qualification (OQ), and Performance Qualification (PQ) are executed on site (note: DQ may precede FAT but is omitted here for simplicity).
This flow is supported by GMP guidance. For example, under EU GMP Annex 15 and ISPE C&Q practices, documented FAT results can often be leveraged into IQ/OQ, reducing duplication. In fact, ISO/ISPE guidelines note that FAT “activities contribute directly to Design Qualification (DQ) and Installation Qualification (IQ) evidence,” helping compress overall qualification time. In practice, a rigorous FAT with proper documentation means your IQ team can reuse those findings (e.g. installation checks already done) rather than re-testing the same points.
A comprehensive FAT protocol for pharmaceutical packaging machinery typically includes the following elements:
Following this checklist helps catch deviations in the factory. For example, industry experts warn against vague FAT records – only quantitative, equipment-specific test data should be accepted. Accepting mere supplier “pass” statements or incomplete checklists can mask problems. Always record measured values and trace them to the specific machine serial number.
A SAT protocol for pharmaceutical packing machines usually covers:
In short, the SAT protocol re-confirms all critical functionality under real conditions. It’s the last checkpoint before commissioning. For example, Jinlupacking notes that a thorough SAT often generates baseline data that can go straight into the IQ/OQ protocols, avoiding retesting of utilities and environment.
Pharma packaging lines (blister, capsule, tablet, cartoning machines) have their own FAT/SAT emphasis. Here are some typical points:
In all cases, both FAT and SAT check that the machine runs at the specified speed and yields the right count/weight/quality with the actual product. Skipping tests (for example, not running real product at FAT) can lead to failures at SAT. As one expert warns, “running a FAT with the OEM’s generic materials is not the same as running it with yours” – if you don’t test real materials in FAT, site issues often emerge later.
Even if a machine passes every item on the FAT checklist, it can still fail SAT if conditions change. Common reasons include:
In short, FAT tests the machine in isolation; SAT tests it in context. Every difference in site conditions or setup is a potential failure mode. A well-executed SAT, however, is the final check to uncover such issues before full production.
When selecting a machine supplier, industry buyers often use FAT/SAT readiness as a key qualifier. For example, Jinlu’s supplier audit guide recommends asking:
These questions help gauge the supplier’s validation maturity. An experienced vendor should readily answer that they deliver machines “audit-ready” with complete FAT/SAT/IQ/OQ packages.
To ensure a smooth acceptance process, buyers can use this quick FAT/SAT checklist:
Following such a checklist avoids surprises. For instance, Seeing a supplier’s packing photos or generic QC notes after the fact is not proof of compliance. The strongest evidence is a complete set of FAT/SAT records tied to the specific machine.
FAT and SAT are both essential checks to ensure your pharmaceutical packaging machines perform reliably and comply with GMP. By thoroughly testing equipment at the vendor’s site (FAT) and again after installation (SAT), you minimize costly surprises and validate that all URS points are met.
Ready to streamline your acceptance tests? Jinlu Packing delivers pharma-grade equipment (blister packers, capsule fillers, tablet presses, counting and cartoning lines, etc.) with full FAT/SAT support. Every machine is shipped with a complete FAT/SAT protocol and IQ/OQ/PQ kit to make your qualification faster and smoother. Contact Jinlu today to discuss your URS and set up FAT/SAT plans for your new equipment, or visit our product pages for Capsule Filling Machines, Blister Packing Machines, Tablet Presses, Counting Machines, Cartoning Machines and more. Our team will help you plan FAT/SAT steps and provide turn-key validation documentation so your project stays on time and compliant.
Get in touch with Jinlu’s experts for FAT/SAT guidance and ensure your new packaging line is validation-ready from day one.
FAT (Factory Acceptance Test) is performed at the equipment manufacturer’s facility before shipment to verify that the machine meets the agreed specifications and functional requirements. SAT (Site Acceptance Test) is performed at the customer’s facility after installation to confirm that the equipment works correctly with the actual site utilities, environment, and connected systems.
FAT allows the buyer and supplier to identify design, manufacturing, control, or performance issues before the machine leaves the manufacturer’s facility. Problems found at this stage are generally easier to investigate and correct because the equipment, engineering team, tools, and test environment are readily available. A well-planned FAT can therefore reduce commissioning delays and avoid unnecessary rework at the customer’s site.
FAT is commonly performed before SAT, but whether it is mandatory depends on the project, contract, equipment, and quality requirements. FAT verifies the equipment before shipment, while SAT verifies the equipment after installation at the customer’s site. For pharmaceutical machinery, the two tests can complement each other rather than replace one another.
Yes. Passing FAT does not guarantee that equipment will pass SAT. FAT is usually performed under controlled factory conditions, while SAT evaluates the machine after transportation, installation, connection to actual utilities, and integration with other equipment. Differences in power supply, compressed air, environmental conditions, product feeding, or line integration can create issues that were not visible during FAT.
A pharmaceutical equipment FAT checklist should be based on the agreed specifications and may include equipment identification, mechanical inspection, electrical systems, PLC/HMI functions, alarms, safety interlocks, machine operation, performance testing, documentation, and agreed acceptance criteria. For packaging machinery, the checklist may also cover production speed, feeding accuracy, sealing, coding, rejection, and other machine-specific functions.
A SAT checklist should focus on the equipment after installation at the customer’s site. Depending on the machine, it may include installation status, electrical connections, compressed air and other utilities, machine operation, safety devices, alarms, communication with upstream and downstream equipment, production performance, and operator functions. The SAT should use acceptance criteria agreed before testing rather than relying only on an informal machine demonstration.
FAT usually involves the supplier’s engineers and the buyer’s representatives (QA/validation, engineering, operations). SAT should include the installing vendor or service team, QA/validation, and the customer’s operations staff. Third-party consultants or inspectors are sometimes included.
Each requires a pre-approved protocol that outlines all tests, acceptance criteria, and responsibilities. During testing, fill in the protocol with real-time data and observations. Deliverables include the executed protocol, a punch-list of any deviations, and a signed final report or certificate. For SAT, also prepare a traceability matrix linking tests back to URS requirements.
FAT and SAT are acceptance tests, while IQ and OQ are typically parts of an equipment qualification strategy. FAT checks the equipment at the manufacturer’s facility before shipment; SAT checks it after installation at the customer’s site. IQ (Installation Qualification) focuses on whether the equipment has been installed according to approved requirements, while OQ (Operational Qualification) verifies that it operates as intended across specified operating ranges. The exact sequence and documentation depend on the company’s validation strategy and project requirements.
FAT can support a pharmaceutical equipment qualification and validation strategy, but FAT itself should not automatically be treated as equivalent to GMP qualification. Its role depends on the equipment, project requirements, risk assessment, and applicable quality system. In some projects, appropriate FAT testing can provide documented evidence that is leveraged during later qualification activities, potentially reducing unnecessary duplication when justified.
